Guralp Systems Limited
Breve Ocean Bottom Seismometer System

Chapter 5. Pre-deployment operations

5.1 Battery charging

The charge status can be calculated by monitoring the current at the start, during, and at the end of charging charging.

Caution: During charging, the battery cells can release some gas which can build up inside the casing. Therefore, before charging, we advise to unscrew the ventilation screw located on the top of the battery canister. Please be aware that when this screw is open, no foreign material (e.g. fluid, dust, particles) should not enter this opening. We recommend, only opening this ventilation when the instrument is in a dry, dust-free and well-ventilated area.

Batteries should be charged according to the following steps:

Caution: If you turn the charger off at the mains, with the battery connected and the green button is left in the “ON” switch, the display will remain lit up. The display will then slowly discharge the battery, so be careful of not leaving it in the mode for an extended period of time.

Fully charging each OBS unit will take approximately 30 hours to complete. To charge the OBS, you will need to plug it into the Deck Unit. The deck unit should also be plugged into a permanent power source.

When not charging on the vessel deck, the batteries will need to be vented during charging.

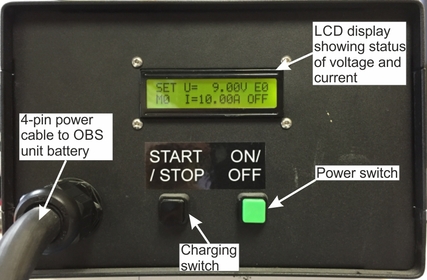

Front panel of the battery charging unit

5.2 Clock synchronisation

The Breve OBS has a temperature-compensated real-time clock which is used for time-stamping recorded data. The clock must be synchronised to GPS time before each deployment. When the system is retrieved at the end of the deployment, the internal clock should be compared to GPS time, and, if desired, a first-order linear correction can subsequently be applied to the time-stamps of the data to compensate for any drift.

1. Power-cycle the OBS Unit(s) and connect the unit(s) to the Deck Control Unit, switch on the Deck Control Unit and the computer, and open the Scream 4.5 software as described in Section 4. Do not connect the GPS to the Deck Control Unit at this point.

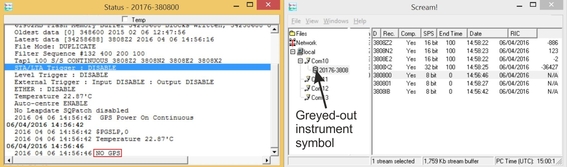

2. Within a few minutes, the connected instrument(s) appear in Scream under the COM** source trees. Each digitiser has an associated icon. These icons are colour-coded to show the status of the associated digitiser. The icons appear initially with both top and bottom clear (). This means that the OBS unit digitiser’s clock has not yet received any synchronisation information. Furthermore, by double-clicking on the ****00 stream (the timing status file), the status “NO GPS” is reported.

Scream main window and timing status file when the clock is not synchronised and the GPS antenna is not connected to the Deck Control Unit.

3. Now connect the GPS antenna and six-pin cable to the GPS port located at the top-right of the main panel of the Deck Control Unit. Ensure that the antenna has a clear view of the sky.

Connecting the GPS antenna to the Deck Control Unit.

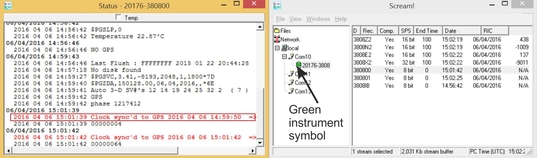

4. Within a few minutes, the instrument symbol in the Scream main window should turn green (), and “Clock sync’d to GPS...” will be reported in the timing status file. This mean that the clock inside the digitiser is now synchronised and the GPS antenna is still connected, constantly trimming the internal clock.

Scream main window and timing status file when the clock is synchronised and the GPS antenna is still connected to the Deck Control Unit.

5. Now the clock will fully trim. When this is complete, the instrument symbol will turn purple () and “TRIMMED” (when offset and drift become very small) will be reported in the status file. The user will not be able to deploy the instrument(s) until this has been achieved.

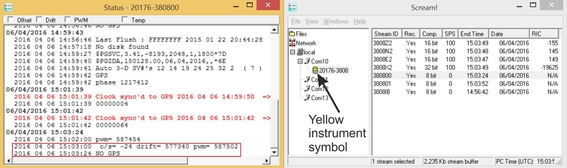

6. Now disconnect the GPS antenna and cable from the deck control unit. The instrument symbol will now turn yellow. “No GPS” will be reported in the timing status file, as well as drift and offset values appearing. These features indicate that there has been an interruption to the incoming timing information, but the internal clock is fully synchronised and no longer relying on the GPS timing source.

Scream main window and timing status file when the clock is synchronised and the GPS antenna is disconnected from the Deck Control Unit.

If the instrument is given a red symbol () when the GPS is connected, the system has received no timing information for over an hour. This normally represents an error condition: contact Güralp Technical Support for advice. Otherwise, a red symbol is normal when the GPS is disconnected.

5.3 Huddle test

A huddle test using all instruments is required before deployment. Güralp recommends that a huddle test of at least 12 hours is conducted in the country of installation to identify the working order of the Breve OBS and all components work. A huddle test also helps the users become familiar with the operation of the equipment.

5.4 Arrangement of ropes

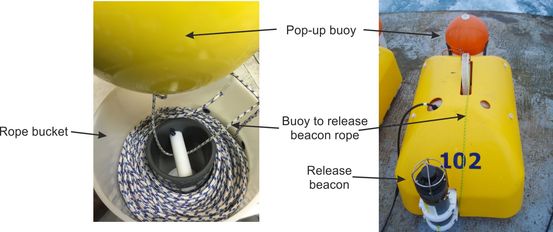

The Breve OBS comprises two main polyester ropes.

One rope is the max. 150 m long piece of rope neatly coiled around the black inner tube in the bucket beneath the pop-up buoy.

The other rope connects the pop-up buoy to the acoustic release beacon. This rope should be laid over the top of the Breve OBS frame, adjacent to the lifting hook, and run down the side of the acoustic release beacon (ensuring that it does not get snagged or caught along any sharp corners or joints and securely fastened to the release block with both arms fully closed.

For more details on the operation of the release beacon, the user is referred to the Quick Start Guide of the Applied Acoustics 1519 Release Beacon, REL-1519-8000-1_1519 (available from Guralp on request).
